Key takeaways
- Odoo cost has two parts: the subscription, paid to Odoo, and the implementation, paid to the partner.
- The subscription is per user per month and varies by region. Multi-company, Studio, custom modules and the external API all need the Custom plan [1].
- Implementation cost follows scope: entities, countries, processes, how much falls outside standard Odoo, data, documents and training.
- Ask every partner to separate standard configuration, customisation and development in the estimate. That is where quotes differ most.
- New compliance rules, such as UAE e-invoicing from 2027, add scope for GCC businesses [3].
Overview
This article explains the cost drivers we look at when we estimate a trading project, with examples from the requirements we wrote for TAM Trading, a chemical trader with three entities selling across five GCC markets.
It does not give a price list. Two trading businesses with the same number of users can need very different budgets, and a figure without the scope behind it is not useful.

Part 1: the Odoo subscription
Odoo charges per user per month. Both the Standard and Custom plans include all apps [1].
The plan matters more than many buyers expect. The Custom plan is needed to run multiple companies in one database, to use Odoo Studio, custom development or the external API, and to host on Odoo.sh or on-premise [1]. Enabling multi-company on a Standard database moves it to the Custom plan [2].
Most trading groups with more than one legal entity will need the Custom plan. TAM runs three entities in one database.
Prices differ by region and change over time. According to an independent price tracker, Odoo raised Custom plan prices in several regions in September 2026 [4]. Check the pricing page from your own country before you budget, and confirm whether the price shown is a first-year discount.
What the subscription does not cover
- Implementation: analysis, configuration, development, migration and training
- Hosting on Odoo.sh or your own servers, if you do not use Odoo Online
- Third-party apps from the Odoo App Store
- Partner support after go-live, beyond Odoo’s own help desk
Part 2: what drives implementation cost
Most of these drivers are set during requirements, as described in how we plan an implementation. Migration is often underestimated; see data migration. For a manufacturing example, see standard Odoo vs what gets built.
Entities and countries
Each company needs its own accounting, taxes, warehouses and documents. TAM sells into the UAE, KSA, Oman, Qatar and Bahrain, and its requirements cover UAE VAT including reverse charge, withholding tax and Zakat where they apply.
Processes in scope
TAM’s scope covers sales, operations, supply chain, finance and HR, written up as 211 numbered requirements. Each process adds workshops, configuration, testing and training.
How much falls outside standard Odoo
This is the biggest driver. Some controls a trader needs are not standard in Odoo 19. In TAM’s design, examples include:
- Blocking order confirmation for high-risk customers (standard Odoo 19 only warns [5])
- A costing sheet on every deal, with a 0.4% bagging loss
- Holding the supplier PO until the customer’s LC or payment is secured
- Commission that follows collected cash
- A non-posting customs invoice for Free Zone exits
Each of these is customisation or development, and each adds cost. The question to ask for each one is whether the control is worth what it costs to build and maintain, or whether a standard process would do.
Integrations
Banks, logistics portals, e-invoicing providers and customer or supplier systems each add an integration to build, test and monitor. Integrations also need the Custom plan when they use the external API [1].
Data migration
Product masters for commodities need design work (packaging types, units, HS codes) before any import. Historical data adds effort for each year you bring across.
Documents and reports
Proformas, customs invoices, delivery notes and tax invoices often need to match the client’s existing layouts. Each layout is a small piece of work. Many layouts add up.
Training and stabilisation
Plan training per team, and a support budget for the first months after go-live.
Compliance changes
New rules add scope. In the UAE, mandatory B2B e-invoicing starts on 1 January 2027 for businesses with annual revenue of AED 50 million or more, and on 1 July 2027 for others. Businesses must appoint an Accredited Service Provider before their go-live date [3]. In Saudi Arabia, ZATCA e-invoicing already applies; see our guide to ZATCA e-invoicing in Odoo.
How scope changes the budget

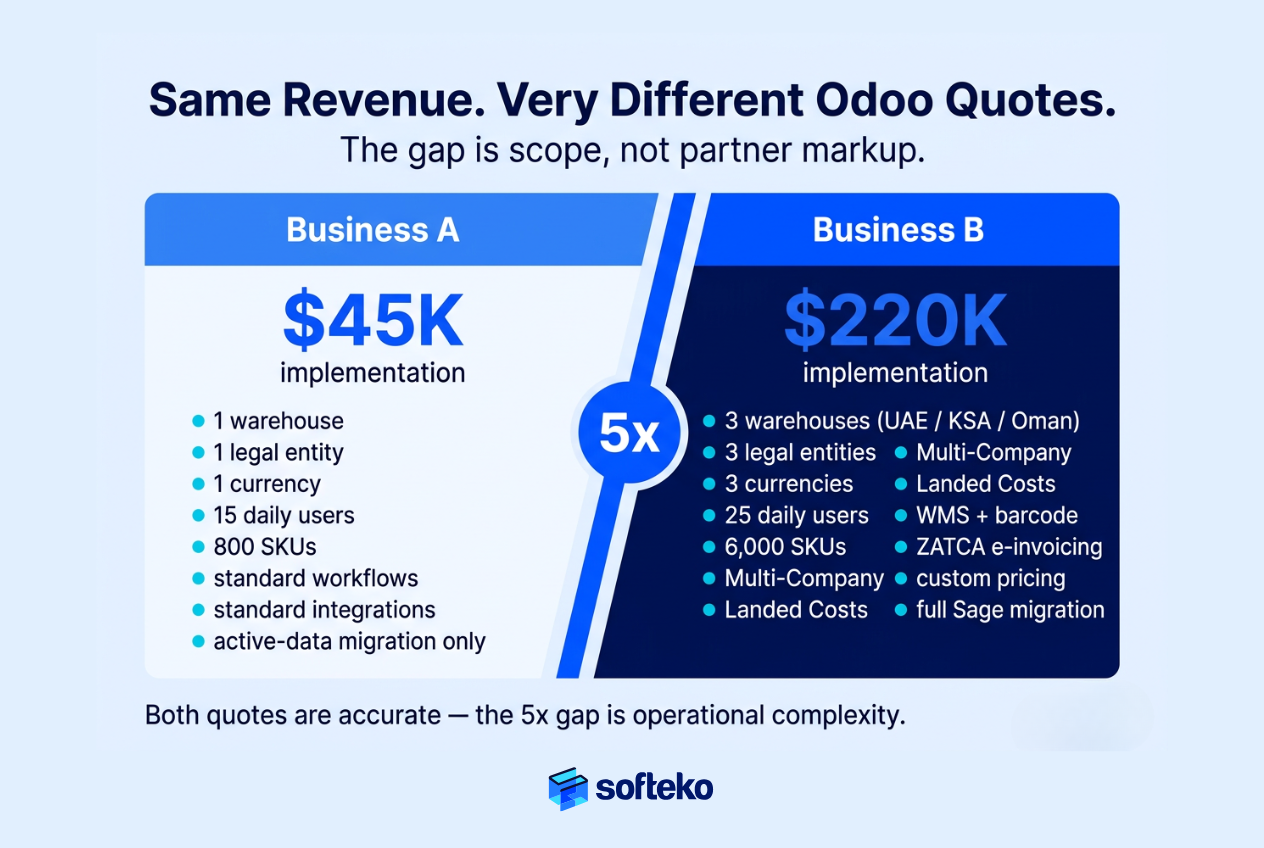

Two illustrative trading businesses with a similar number of users:
| Driver | Trader A | Trader B |
|---|---|---|
| Legal entities | 1 | 3 |
| Countries | 1 | 5 |
| Odoo plan | Standard | Custom |
| Processes in scope | Sales, purchase, inventory, accounting | Plus logistics, LC, commission, HR |
| Controls outside standard | Few | Credit blocks, payment gate, costing sheet, customs invoice |
| Integrations | None | Bank, e-invoicing, 3PL |
| Data to migrate | Open items only | Open items plus historical invoices |
| Likely approach | Mostly standard, short project | Phased project with development |
Trader B’s project will cost several times more than Trader A’s. The user count is similar. The scope is not.
If you want a realistic figure for your own business, send us your entities, processes and must-have controls.
How we structure an estimate
- High level first, then refined. We give a high-level estimate early and refine it once the detailed requirements are written.
- Requirements tagged by type. Each requirement is marked as standard Odoo, customisation (custom fields, views, approval flows, document formats inside Odoo’s framework) or development. On one current project, the planned split was about 60% standard, 30% customisation and 10% development.
- Phased delivery. Requirement analysis; configuration, customisation, development and data migration; training and acceptance testing; go-live. Work runs in two-week sprints.
- Included: workshops and solution blueprint, module set-up, customisation, approval flows, dashboards and reports, agreed integrations, data migration, user roles and security, testing, training and manuals, go-live and early stabilisation.
- Separate: ongoing maintenance and support, under an annual agreement. New requirements raised after sign-off are estimated as a later phase.

Estimates also allow for the mistakes we plan for.
Build your own budget

A simple budget has six lines, each with an owner:
| Budget line | Typical owner |
|---|---|
| Odoo subscription for year one | CFO or IT |
| Implementation by the partner | Project sponsor |
| Data migration effort on the client side | Department heads |
| Integrations and third-party apps | IT or procurement |
| Training and time away from daily work | HR and department heads |
| Support after go-live | CFO |
Keep a contingency for decisions that are still open when the budget is approved, and release it only through a change request.

Questions to ask every Odoo partner
- Which plan (Standard or Custom) does your estimate assume, and why?
- How many requirements are standard, customised or developed?
- What data is included in migration, and how many years of history?
- Which document layouts are included?
- Which integrations are included, and who maintains them?
- What happens to new requirements after sign-off?
- What does support cost after go-live?
FAQ
Is Odoo cheaper than other ERP systems?
The subscription is often a smaller part of the total. Compare the full scope, not only the licence.
Do we need the Custom plan?
If you run more than one company in one database, or need Studio, custom modules or the API, yes [1].
Why are two Odoo quotes so different?
Usually different assumptions about scope: how much is configured versus developed, and what is migrated. Ask each partner to list their assumptions.
Does Odoo cost the same in every country?
No. Odoo prices by region, so check the pricing page from your own country [1].
Will UAE e-invoicing add to our project?
If you invoice other businesses in the UAE, yes. Plan for the e-invoicing setup and your service provider before your mandatory date [3].
Get an estimate based on your scope
Send us your entities, processes and must-have controls. We will tell you what drives the cost in your case. Read more about our Odoo implementation service.
